Question: You are an assistant to Percival Young,

You are an assistant to Percival Young, president of G&L Construction. He has asked you to prepare a brief report on the status of the Shoreline Stadium project. Shoreline stadium is a 47,000-seat professional baseball stadium. Construction started on April 3, 2018, and the stadium is schedule to be completed on March 25, 2020. The project is estimated to cost $310,000,000. There is a $35 million management reserve to deal with unexpected problems and delays. The stadium must be ready for the 2020 major league season. G&L would accrue a $250,000 per day penalty for not meeting the April 3, 2020 deadline. G&L expects to make more than $3 million on the project. The stadium is one of several major projects G&L has under way in North America, including a professional soccer stadium and another baseball stadium, which broke ground last month. It is 8/8/2019 the day after the key milestone “Start Installing Seats” was to occur. Tables C13.1 and C13.2 contain information submitted by your counterpart at the Shoreline site from which you are to prepare your report. Use the appropriate indexes/ information to prepare a report informing Mr. Young on the overall status of the Shoreline project in terms of costs and schedule. Note: Mr. Young is not interested in specifics, but just how well the overall project is doing and if there is a need to take corrective action.
You are an assistant to Percival Young, president of G&L Construction. He has asked you to prepare a brief report on the status of the Shoreline Stadium project.
Shoreline stadium is a 47,000-seat professional baseball stadium. Construction started on April 3, 2018, and the stadium is schedule to be completed on March 25, 2020. The project is estimated to cost $310,000,000. There is a $35 million management reserve to deal with unexpected problems and delays.
The stadium must be ready for the 2020 major league season. G&L would accrue a $250,000 per day penalty for not meeting the April 3, 2020 deadline. G&L expects to make more than $3 million on the project. The stadium is one of several major projects G&L has under way in North America, including a professional soccer stadium and another baseball stadium, which broke ground last month.
 It is 8/8/2019 the day after the key milestone “Start Installing Seats” was to occur.
 Tables C13.1 and C13.2 contain information submitted by your counterpart at the Shoreline site from which you are to prepare your report. Use the appropriate indexes/ information to prepare a report informing Mr. Young on the overall status of the
 Shoreline project in terms of costs and schedule. Note: Mr. Young is not interested in specifics, but just how well the overall project is doing and if there is a need to take corrective action.


You are an assistant to Percival Young, president of G&L Construction. He has asked you to prepare a brief report on the status of the Shoreline Stadium project.
Shoreline stadium is a 47,000-seat professional baseball stadium. Construction started on April 3, 2018, and the stadium is schedule to be completed on March 25, 2020. The project is estimated to cost $310,000,000. There is a $35 million management reserve to deal with unexpected problems and delays.
The stadium must be ready for the 2020 major league season. G&L would accrue a $250,000 per day penalty for not meeting the April 3, 2020 deadline. G&L expects to make more than $3 million on the project. The stadium is one of several major projects G&L has under way in North America, including a professional soccer stadium and another baseball stadium, which broke ground last month.
 It is 8/8/2019 the day after the key milestone “Start Installing Seats” was to occur.
 Tables C13.1 and C13.2 contain information submitted by your counterpart at the Shoreline site from which you are to prepare your report. Use the appropriate indexes/ information to prepare a report informing Mr. Young on the overall status of the
 Shoreline project in terms of costs and schedule. Note: Mr. Young is not interested in specifics, but just how well the overall project is doing and if there is a need to take corrective action.





Transcribed Image Text:

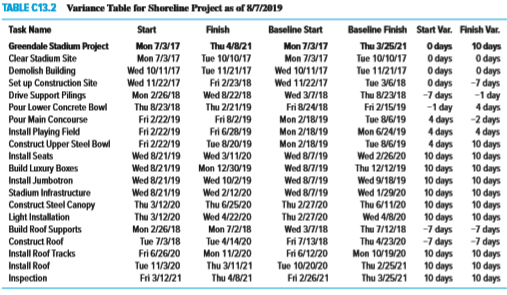

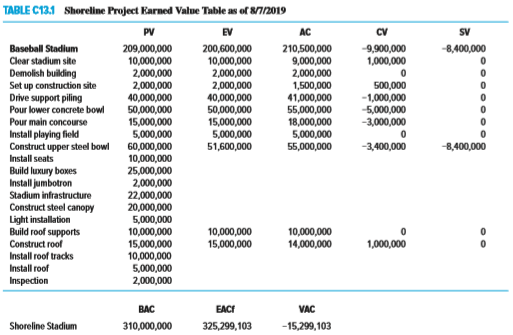

TABLE C13.1 Shoreline Project Karned Value Table as of 8/7/2019 PV EV AC CV SV Baseball Stadium Clear stadium site Demolish building Set up construction site Drive support piling 209,000,000 10,000,000 2,000,000 200,600,000 10,000,000 2,000,000 210,500,000 9,000,000 2,000,000 1,500,000 -9,900,000 1,000,000 -8,400,000 2,000,000 40,000,000 50,000,000 15,000,000 5,000,000 2,000,000 40,000,000 50,000,000 15,000,000 5,000,000 51,600,000 500,000 -1,000,000 41,000,000 55,000,000 18,000,000 5,000,000 55,000,000 Pour lower concrete bowl -5,000,000 Pour main concourse -3,000,000 Install playing field Construct upper steel bowl Install seats -3,400,000 60,000,000 10,000,000 25,000,000 2,000,000 22,000,000 20,000,000 -8,400,000 Build luxury boxes Install jumbotron Stadium infrastructure Construct steel canopy Light installation Build roof supports 5,000,000 10,000,000 15,000,000 10,000,000 5,000,000 10,000,000 15,000,000 10,000,000 Construct roof Install roof tracks Install roof 14,000,000 1,000,000 Inspection 2,000,000 BAC EACI VAC Shoreline Stadium 310,000,000 325,299,103 -15,299,103 TABLE C13.2 Variance Table for Shoreline Project as of 87/2019 Task Name Start Finish Baseline Start Baseline Finish Start Var. Finish Var. O days O days O days O days -1 days -1 day 4 days 4 days 4 days 10 days 10 days 10 days 10 days 10 days 10 days -1 days -1 days 10 days 10 days 10 days Greendale Stadium Project Clear Stadium Site Demolish Building Set up Construction Site Drive Support Pilings Pour Lower Concrete Bowl Pour Main Concourse 10 days O days O days -1 days -1 day 4 days -2 days 4 days 10 days 10 days 10 days 10 days 10 days 10 days 10 days -1 days -1 days 10 days 10 days 10 days Mon 7/3/17 Mon 7/3/17 Wed 10/11/17 Thu 4/8/21 Tue 10/10/17 Tue 11/21/17 Fri 2/23/18 Mon 7/3/17 Mon 7/3/17 Wed 10/11/17 Wed 11/22/17 Thu 3/25/21 Tue 10/10/17 Tue 11/21/17 Tue 3/6/18 Wed 11/22/17 Mon 2/26/18 Thu 8/23/18 Fri 2/22/19 Fri 2/22/19 Wed 8/22/18 Thu 2/21/19 Fri 8/2/19 Fri 6/28/19 Wed 3/7/18 Fri 8/24/18 Mon 2/18/19 Mon 2/18/19 Thu 8/23/18 Fri 2/15/19 Tue 8/6/19 Mon 6/24/19 Install Playing Field Construct Upper Steel Bowl Install Seats Fri 2/22/19 Wed 8/21/19 Tоe 8/20/19 Wed 3/11/20 Mon 2/18/19 Wed 8/7/19 Wed 8/7/19 Wed 8/7/19 Tue 8/6/19 Wed 2/26/20 Thu 12/12/19 Wed 9/18/19 Wed 1/29/20 Thu 6/11/20 Build Luxury Boxes Install Jumbotron Stadium Infrastructure Construct Steel Canopy Light Installation Build Roof Supports Construct Roof Install Roof Tracks Install Roof Wed 8/21/19 Wed 8/21/19 Mon 12/30/19 Wed 10/2/19 Wed 8/21/19 Wed 2/12/20 Wed 8/7/19 Thu 2/27/20 Thu 3/12/20 Thu 3/12/20 Thu 6/25/20 Wed 4/22/20 Mon 2/26/18 Tue 7/3/18 Fri 6/26/20 Tue 11/3/20 Mon 7/2/18 Tue 4/14/20 Mon 11/2/20 Thu 3/11/21 Thu 2/27/20 Wed 3/7/18 Fri 7/13/18 Fri 6/12/20 Tue 10/20/20 Wed 4/8/20 Thu 7/12/18 Thu 4/23/20 Mon 10/19/20 Thu 2/25/21 Inspection Fri 3/12/21 Thu 4/8/21 Fri 2/26/21 Thu 3/25/21


> What is iterative incremental development? Why is it useful for developing new products?

> Why is the traditional project management approach less effective when project scope and technology are not well known?

> What are the differences between a self-organizing team and a conventional project team?

> What similarities and differences exist between a traditional project manager and a Scrum master?

> You manage a hotel resort located on the South Beach on the Island of Kauai in Hawaii. You are shifting the focus of your resort from a traditional fun-in-the-sun destination to eco-tourism. (Eco-tourism focuses on environmental awareness and education.)

> What are the advantages of Agile PM? What are the disadvantages of Agile PM?

> You’ve just taken over a project from another project manager and have come back from a very uncomfortable meeting with your business sponsor. In the meeting, the sponsor told you how dissatisfied he is with the project’s performance to date and that he’

> Break into small groups and discuss the following question: What organizational, group, individual, and project factors do you think would promote the successful adoption of Agile PM methodologies like Scrum? Why?

> Kendra Hua had worked for six years as a software engineer in the IT department at Point 2 Point (P2P), a large freight moving company. She liked her job and the people she worked with. While she did some maintenance work, she worked primarily on project

> Why is it important to honor the customs and traditions of a country when working on an international project?

> What role do local intermediaries play in helping an outsider complete a project?

> How do environmental factors affect project implementation?

> How should you go about preparing yourself for an international project?

> What is culture shock? What can you do to reduce the negative effects of culture shock?

> Interview someone who has worked or lived in a foreign country for more than six months. a. What was his experience with culture shock? b. What did he learn about the culture of the country he lived in? c. What advice would he give to someone who woul

> The Custom Bike Company has set up a weighted scoring matrix for evaluation of potential projects. Below are five projects under consideration. a. Using the scoring matrix in the following chart, which project would you rate highest? Lowest? b. If the w

> Place in order the following countries in terms of what you would think would be the least to most corrupt: United States, Denmark, Saudi Arabia, Russia, Australia, Hong Kong, Nepal, China, Kenya, Indonesia, Botswana, Greece, Chile. Use an Internet sea

> Try as best you can to apply the Kluckhohn-Strodtbeck cross-cultural framework to the four countries discussed in this chapter: Mexico, France, Saudi Arabia, and China. Where do you think these countries lie on each of the cultural issues?

> Michael Thomas shouted, “Sasha, Tor-Tor, we’ve got to go! Our driver is waiting for us.” Thomas’s two daughters were fighting over who would get the last orange for lunch that day. Victoria (“Tor-Tor”) prevailed as she grabbed the orange and ran out the

> On December 26, 2004, an earthquake reaching 9.1 on the Richter scale triggered a series of devastating tsunamis off the coast of Indonesia. They spread throughout the Indian Ocean, killing large numbers of people and inundating coastal communities acros

> What major information would you expect to find in a project review?

> Why is it difficult to perform a truly independent, objective review?

> How does the project closure review differ from the performance measurement control system discussed in Chapter 13?

> Advocates of retrospective methodology claim there are distinguishing characteristics that increase its value over past lessons learned methods. What are they? How does each characteristic enhance project closure and review?

> Why should you separate performance reviews from pay reviews? How do you do this?

> Comment on the following statement: “We cannot afford to terminate the project now. We have already spent more than 50 percent of the project budget.”

> Given the time-phased work packages, complete the baseline budget form for the project. Time-phased budget ($ 000) Week 1 2 3 4 5 7 8 9 1O Task Budget o 6 Activity 1 4 4 13 2 2 4 2 2 Activity 2 6 Activity 3 10 Activity 4 2 3 3 8 Activity 5 3 2 1 Tot

> Consider a course that you recently completed. Perform a review of the course (the course represents a project and the course syllabus represents the project plan).

> What are some of the lessons learned from a recent project in your organization? Was a retrospective done? What action plans were generated to improve processes as a result of the project?

> Imagine you are conducting a review of the International Space Station project. Research press coverage and the Internet to collect information on the current status of the project. What are the successes and failures to date? What forecasts would you ma

> Olaf Gundersen, the CEO of Wireless Telecom Company, is in a quandary. Last year he accepted the Maximum Megahertz Project suggested by six up-and-coming young R&D corporate stars. Although Olaf did not truly understand the technical importance of the pr

> How does a tracking Gantt chart help communicate project progress?

> Schedule variance (SV) is in dollars and does not directly represent time. Why is it still useful?

> How does earned value give a clearer picture of project schedule and cost status than a simple plan versus actual system?

> On day 51 a project has an earned value of $600, an actual cost of $650, and a planned cost of $560. Compute the SV, CV, and CPI for the project. What is your assessment of the project on day 51?

> In month 9 the following project information is available: actual cost is $2,000, earned value is $2,100, and planned cost is $2,400. Compute the SV and CV for the project.

> How would a project manager use the CPI?

> Hector Gaming Company Hector Gaming Company (HGC) is an educational gaming company specializing in young children’s educational games. HGC has just completed their fourth year of operation. This year was a banner year for HGC. The company received a larg

> Fatma settled down for lunch at the Yank Sing Chinese restaurant. She was early and took the time to catch up on her e-mail. Soon she would be joined by Jasper and Viktoria, two fellow 2014 grads from Virginia Tech in Blacksburg, Virginia. Jasper worke

> Why is it important for project managers to resist changes to the project baseline? Under what conditions would a project manager make changes to a baseline? When would a project manager not allow changes to a baseline?

> What are the differences between BAC and EAC?

> Given the following project network, baseline, and status information, develop status reports for periods 2, 4, 6, 8 and complete the performance indexes table. Calculate the EACf and the VACf. Based on your data, what is your assessment of the current s

> Given the project network and baseline information below, complete the form to develop a status report for the project at the end of period 4 and the end of period 8. From the data you have collected and computed for periods 4 and 8, what information are

> * Part A. You are in charge of the Aurora Project. Given the following project network, baseline, and status information, develop status reports for periods 1–8 and complete the performance indexes table. Calculate the EACf and VACf. Ba

> The following data have been collected for a British health care IT project for two week reporting periods 2 through 12. Compute the SV, CV, SPI, and CPI for each period. Plot the EV and the AC on the summary graph provided. Plot the SPI, CPI, and PCIB o

> The following labor hours data have been collected for a nanotechnology project for periods 1 through 6. Compute the SV, CV, SPI, and CPI for each period. Plot the EV and the AC on the summary graph provided (or a similar one). Plot the SPI, CPI, and PCI

> Wil Fence is a large timber and Christmas tree farmer who is attending a project management class in the spring, his off season. When the class topic came to earned value, he was perplexed. Isn’t he using EV? Each summer Wil hires crews to shear fields o

> Scanner Project You have been serving as Electroscan’s project manager and are now well along in the project. Develop a narrative status report for the board of directors of the chain store that discusses the status of the project to da

> Assume you are a member of a class on project management. Each student will join a team of 5–7 students who will be responsible for creating, planning, and executing a fund raising project for a designated charity. The fund raising proj

> Given the information provided for development of a catalog product return process for periods 1 through 5, assign the PV values (using the rules) to develop a baseline for the project. Compute the SV, CV, SPI, and CPI for each period. Explain to the own

> Given the information provided for development of a product warranty project for periods 1 through 7, compute the SV, CV, SPI, and CPI for each period. Plot the EV and the AC on the PV graph provided. Explain to the owner your assessment of the project a

> What does the term “escalate” refer to, and why is it essential to project success?

> What are the best practices used by firms to outsource project work?

> Why do firms outsource project work?

> How can a project manager influence customer expectations and perceptions?

> What does the acronym BATNA refer to and why is it important to being a successful negotiator?

> Why is the principled negotiation approach recommended for negotiating agreements on projects?

> Break into groups of four to five students. Assign half of the groups the role of Owner and the other half the role of Contractor. Owners: After saving for many years you are about to hire a contractor to build your “dream home.” What are your objective

> The National Oceanic Research Institute is planning a research study on global warming in Antarctica. The 16-month network schedule is presented below. It is followed by budgets for each activity. Create a time-phased budget for the research project in t

> Sitting in her office, Karin Chung is reviewing the past four months of the large corporate accounting software installation project she has been managing. Everything seemed so well planned before the project started. Each company division had a task for

> Shell Case Fabricators (SCF) designs and builds shell casings that enclose electronic products such as calculators, cell phones, modems. Typically the cases are plastic or plastic compounds. SCF has six different production lines that cover different ty

> Goldrush Electronics (GE) produces a range of electronic products. GE has a strong commitment to project management. GE operates as a projectized organization with each project organized as a fully dedicated team. The compensation system is based on a 40

> Chad Cromwell, head of university housing, gazed up at the tower at Buxton Hall and smiled as he walked toward the landmark building. Buxton Hall was built in 1927 as a residential complex for over 350 students at Pacifica State University. At the time B

> For what kinds of projects would you recommend that a fixed-price contract be used? For what kinds of projects would you recommend that a cost-plus contract be used?

> What are the fundamental differences between fixed-price and cost-plus contracts?

> What are the elements of an effective project vision? Why are they important?

> What are the differences between the five-stage model of team development and the punctuated equilibrium model?

> What can a project manager do to avoid some of the pitfalls of a highly cohesive project team?

> What are the unique challenges of managing a virtual project team?

> The technical and sociocultural dimensions of project management are two sides to the same coin. Explain.

> When would it be appropriate to hold a formal team-building session on a project?

> What is the difference between functional and dysfunctional conflict on a project?

> Why should a project manager emphasize group rewards over individual rewards?

> Assume that you have the following decision-making options: (1) make the decision on your own with available information, (2) consult others before making a decision, and (3) call a meeting and reach a consensus, seeking to arrive at a final decision eve

> Amber Briggs looked nervously at her watch as she sat at the front of a large table in the cafeteria at Kerzner Office Equipment. It was now 10 minutes after 3:00 and only 10 of the 14 members had arrived for the first meeting of the Kerzner anniversary

> Franklin Equipment, Ltd. (FEL), with headquarters and main fabrication facilities in Saint John, New Brunswick, was founded 75 years ago to fabricate custom-designed large machines for construction businesses in the Maritime Provinces. Over the years its

> Tran was taking his dog Callie on her evening walk as the sun began to set over the coastal range. He looked forward to this time of the day. It was an opportunity to enjoy some peace and quiet. It was also a time to review events on the Ajax project an

> Why is it critical to keep the project sponsor informed?

> What does the exchange model of influence suggest you do to build cooperative relationships to complete a project?

> Why is a conductor of an orchestra an appropriate metaphor for being a project manager? What aspects of project managing are not reflected by this metaphor? Can you think of other metaphors that would be appropriate?

> What are some of the key environmental forces that have changed the way projects are managed? What has been the effect of these forces on the management of projects?

> What is the difference between leading and managing a project?

> Why is trust a function of both character and competence?

> Why is it important to build a relationship before you need it?

> What differences would you expect to see between the kinds of influence currencies that a project manager in a functional matrix would use and the influence a project manager of a dedicated project team would use?

> You are the project manager for the Seaburst construction project. So far the project is progressing ahead of schedule and below budget. You attribute this in part to the good working relationship you have with the carpenters, plumbers, electricians, and

> You returned from a project staffing meeting in which future project assignments were finalized. Despite your best efforts, you were unable to persuade the director of project management to promote one of your best assistants, Jack Nietzche, to a project

> You are managing the renovation of the Old Princeton Landing Bar and Grill. The project is on schedule despite receiving a late shipment of paint. The paint was supposed to arrive on 1/30, but instead arrived on 2/1. The assistant store manager apologize

> You are a test engineer on the Bridge project at Ryman Pharmaceuticals in Nashville, Tennessee. You have just completed conductivity tests of a new electrochemical compound. The results exceeded expectations. This new compound should revolutionize the in

> You are responsible for installing the new Double E production line. Your team has collected estimates and used the WBS to generate a project schedule. You have confidence in the schedule and the work your team has done. You report to top management that

> You work for a large consulting firm and were assigned to the Gold Star LAN project. Work on the project is nearly completed and your clients at Gold Star appear to be pleased with your performance. During the course of the project, changes in the origin

> Define a project. What are five characteristics that help differentiate projects from other functions carried out in the daily operations of the organization?

> You are driving to a project status report meeting with your client. You encountered a significant technical problem on the project that has put your project behind schedule. This is not good news because completion time is the number one priority for th

> Garth Hudson was a 29-year-old graduate of Eastern State University (ESU) with a B.S. degree in management information systems. After graduation he worked for seven years at Bluegrass Systems in Louisville, Kentucky. While at ESU he worked part time for

> Cerberus is a successful producer of specialty chemicals. It operates nine large campus sites in the United States, with a number of different business units on each site. These business units operate independently, with direct reporting to corporate he

> Tom Bray was mulling over today’s work schedule as he looked across the bay at the storm that was rolling in. It was the second official day of the Pegasus project and now the real work was about to begin. Pegasus was a two-month renovation project for

> How can a cost-duration graph be used by the project manager? Explain.

> It is possible to shorten the critical path and save money. Explain how.

> What are the advantages and disadvantages of reducing project scope to accelerate a project? What can be done to reduce the disadvantages?

> What are five common reasons for crashing a project?
